Lean Tool

Value Stream Map Maker for Lean & Process Improvement

Describe your process, cycle times, and inventory and get a value stream map with process boxes, data boxes, inventory triangles, push or pull arrows, and a lead-time timeline. Review the numbers, then download a PNG.

Process boxes, data boxes, inventory trianglesPush, pull, kanban, and FIFO symbols

AI Value Stream Map Maker

Describe your process

Free to try ·

Preview

Your value stream map will appear here

Include the numbers you want shown, then check them in the result

Need totals you can rely on? Use the exact VSM builder below: type the numbers, get the map and the math.

Exact VSM builder: type the numbers, get a map that adds up

The generator above draws from a description, so a total can be wrong. This builder works the other way: you enter the process data, and it draws the map and calculates takt time, inventory days, production lead time, value-added time, and process cycle efficiency with the formulas in the calculations section below. It covers a linear current-state map with 2 to 8 processes. Pull systems, supermarkets, and kanban are not drawn here; describe them in the generator instead.

Map data

Linear current-state map with 2 to 8 processes. Inventory is the pieces waiting in front of each process; finished goods are counted after the last one.

#ProcessC/T (s)C/O (min)Uptime (%)OperatorsInventory before (pcs)Move or delete
1
2
3
4

CSV: one row per process with a name column first, then cycle_time_s, changeover_min, uptime_pct, operators and inventory_before_pcs. Optional #demand_per_day, #shifts and #minutes_per_shift rows set the demand and working time. Comma, semicolon or tab separated. Changeover and uptime appear on the map but do not change the totals.

Takt time
60 s
Production lead time
10.01 days
Value-added time
155 s
Process cycle efficiency
0.061%

Inventory total: 4,200 pcs, 10.0 days of demand.

Fictional stamped bracket line: current stateCurrent state, push production. Inventory days = pieces ÷ daily demand.Steel supplierAssembly plant420 pcs / dayProduction controlOrdersScheduleI840 pcs2.0 daysI1,680 pcs4.0 daysI1,260 pcs3.0 daysI420 pcs1.0 daysStampingC/T30 sC/O10 minUptime95%Operators2WeldingC/T45 sC/O15 minUptime90%Operators2AssemblyC/T60 sC/O20 minUptime98%Operators3ShippingC/T20 sC/O5 minUptime100%Operators12.0 d30 s4.0 d45 s3.0 d60 s1.0 d20 s0.0 dwaitworkTakt time60 sProduction lead time10.01 daysValue-added time155 sProcess cycle efficiency0.061%Takt time = 25,200 s available per day ÷ 420 pcs per day.Lead time = inventory days + value-added time ÷ available time per day. PCE = value-added time ÷ lead time.Fictional example, for illustration only
Exact current-state value stream map of a fictional stamped bracket line with four processes, inventory triangles, a time ladder, and totals of 60 seconds takt time, 10.01 days lead time, 155 seconds value-added time
Exported from the builder above with the sample data. The plant and the numbers are fictional.

What is a value stream map?

A value stream map (VSM) is a lean tool that draws every step material and information take from supplier to customer, then adds the time data: how long each step works on the product and how long the product waits between steps. The result is one page that shows where the lead time actually goes. In most factories, waiting is the overwhelming share, and the map makes that visible.

Use it for lean projects, kaizen events, and Six Sigma analysis, and for office and healthcare processes through the service variant. If you only need to agree on scope, start with a SIPOC diagram.

Check the numbers. The generator draws the symbols and layout from your description. AI images can misplace a value or mix up a symbol, so verify every data box, inventory count, and timeline total against your own measurements before sharing the map.

If the numbers matter, build the map in the exact VSM builder instead: it calculates takt time, lead time, and process cycle efficiency from your data.

Value stream map symbols and what they mean

These are the symbols most VSMs use, following the conventions from Learning to See. The icons below are exact drawings; the generator follows the same set.

SymbolNameWhat it meansDrawing tip
Process box with data boxOne area of continuous flow. The box under it holds the data: C/T (cycle time), C/O (changeover time), uptime, number of operators, available time, and yield.Draw one box per area of flow, not one per task.
Customer / supplierThe outside source of material (left) and destination of product (right). Customer demand per day goes in or under it.Put the customer on the right and the supplier on the left.
Inventory triangleStock waiting between steps, with the quantity and the time it covers underneath.Write quantity and days of demand, for example 1,200 pcs (2 days).
Push arrowMaterial moved to the next step on a schedule, not because the next step asked for it.Each striped arrow is a place to ask if a pull system could replace it.
SupermarketA controlled stock that a downstream step pulls from. The upstream step refills only what was taken.Add the maximum quantity and the pull signal next to it.
Withdrawal kanbanThe card or signal that tells the upstream step what to replace. A dashed line shows the loop.Show production kanban separately if the upstream step also uses one.
FIFO laneA first-in, first-out lane with a maximum quantity that links two processes without a full supermarket.Write the maximum, for example "FIFO max 100".
Information flowA straight arrow is manual information such as a schedule or report. A zigzag arrow is electronic information such as EDI or MRP.Label every arrow: weekly forecast, daily orders, daily schedule.
Kaizen burstA starburst marking an improvement to make at that point. Draw it on the current state, then carry the changes into the future-state map.Name the improvement, for example "Reduce changeover".
OperatorA person at a process. It shows how many people the step needs and where workload can be balanced.Match it to the "operators" line in the data box.
Timeline ladderUpper steps are waiting time (inventory days) and lower steps are processing time. The two sums give lead time and value-added time.Keep the units consistent: days on the top, seconds on the bottom.

How to make a value stream map, step by step

  1. 1

    Choose one product family and the customer demand

    Pick the products that share most of their processing steps. Write the customer demand per day and compute takt time: available working seconds divided by daily demand. With 25,200 working seconds and 420 units a day, takt time is 60 seconds.

  2. 2

    Walk the flow from shipping back to the first step

    Start at the customer and walk upstream. Every step you see on the floor becomes a process box. Collect the numbers yourself instead of copying them from the routing sheet.

  3. 3

    Fill in a data box for each process

    Record cycle time (C/T), changeover time (C/O), uptime, operators, and available time. These five lines are enough for a first map.

  4. 4

    Count the inventory between steps

    Count what is physically waiting and convert it to days of demand: quantity divided by daily demand. 1,200 pieces at 600 a day is 2 days.

  5. 5

    Add information flow and production control

    Show how the customer order reaches the plant, how the schedule reaches each step, and what is pulled and what is pushed. Label every arrow with its frequency.

  6. 6

    Draw the timeline and calculate

    Add up the inventory days for lead time and the cycle times for value-added time. The ratio of the two, often well under 5 percent, shows how much of the lead time is waiting.

  7. 7

    Mark improvements and draw the future state

    Use kaizen bursts on the current state where the data points to waste, then redraw the map with flow, supermarkets, and a single pacemaker process.

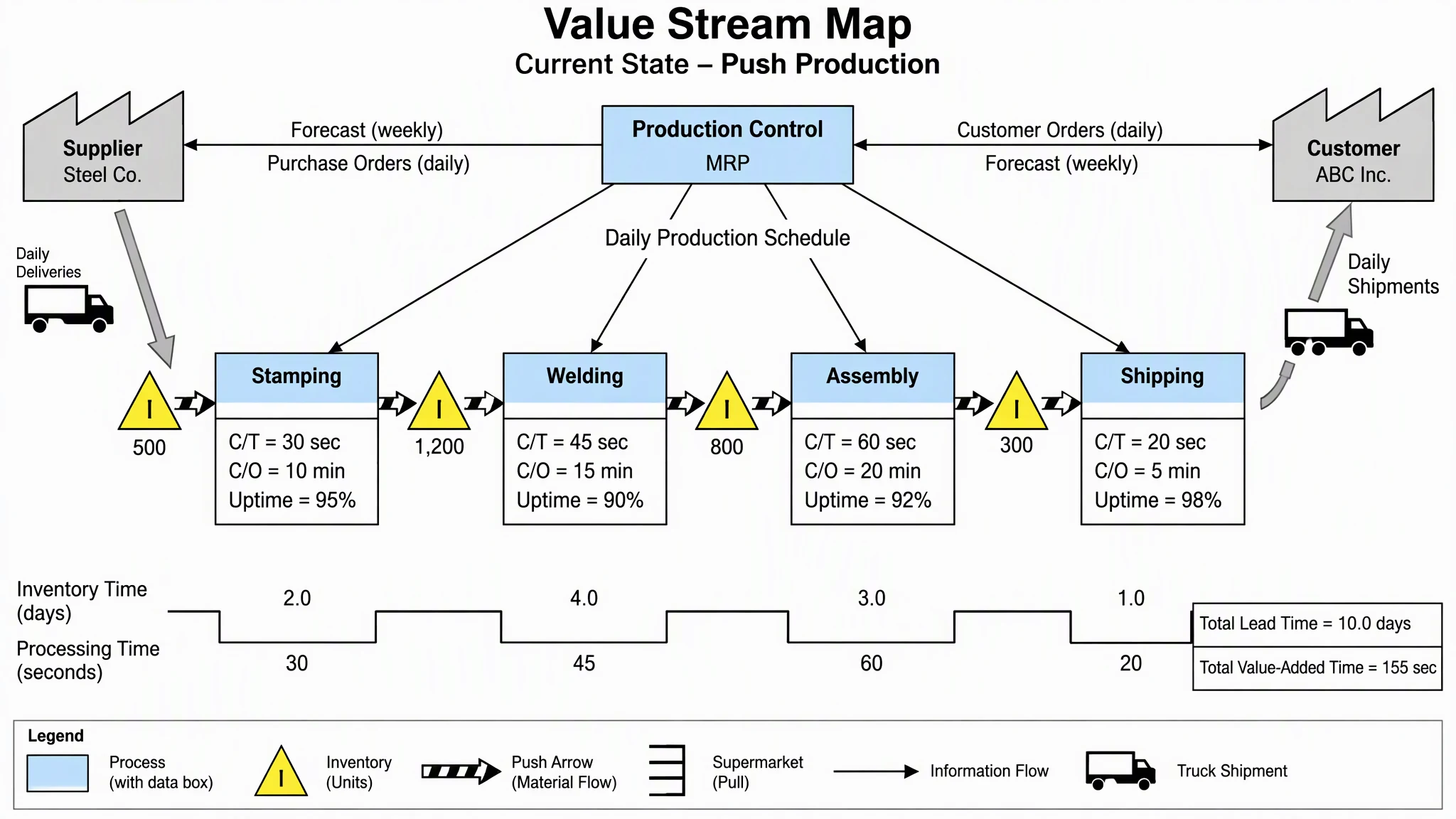

Current-state value stream map of a push production line with inventory triangles, data boxes, and a timeline
Generated from the first sample prompt above. The timeline adds the inventory days (2 + 4 + 3 + 1 = 10 days) and the processing times (30 + 45 + 60 + 20 = 155 seconds).

Value stream map calculations

Five formulas cover most of the numbers on a current-state map. The examples use the push-production map above.

MetricFormulaExample
Takt timeAvailable working time per day / customer demand per day25,200 s / 420 units = 60 s per unit
Inventory daysInventory quantity / customer demand per day1,200 pcs / 600 pcs per day = 2.0 days
Production lead timeSum of inventory days (and any wait time) plus processing time2.0 + 4.0 + 3.0 + 1.0 days, plus 155 s of processing = about 10 days
Value-added timeSum of the cycle times of the value-adding steps30 + 45 + 60 + 20 = 155 s
Process cycle efficiencyValue-added time / lead time155 s / (10 days x 25,200 s of working time) = about 0.06 percent

Example values are illustrative, for a 7-hour working day. Use the working time and demand from your own plant.

Common value stream mapping mistakes

  • Mapping every task instead of every area of flow. A VSM is not a flowchart; one process box covers a group of steps that run together.
  • Using standard times from the routing instead of measured ones. Walk the floor and time it.
  • Mapping several product families on one page. Pick one family and map the others later.
  • Skipping information flow. The scheduling system is often the biggest source of inventory.
  • Counting inventory in pieces only. Convert it to days of demand so the timeline adds up.
  • Drawing the future state before the current state has real numbers.

VSM vs SIPOC vs process flow diagram vs swimlane

DiagramWhat it showsBest for
Value stream mapMaterial and information flow with cycle times, inventory, and wait timesLean waste analysis and lead-time reduction
SIPOC diagramSuppliers, inputs, 4 to 7 steps, outputs, and customers on one pageScoping a project before detailed mapping
Process flow diagramMajor equipment and material streams, often with a stream tableChemical and process plant design
Swimlane diagramSteps and decisions split by role or departmentFinding handoff delays and ownership gaps

For a chemical or plant process with equipment and streams, use the process flow diagram generator. To split the same steps by role, use the swimlane diagram generator. After the map shows where the delay is, a fishbone diagram and a Pareto chart help you find and rank the causes.

Value Stream Map Examples

Generated with this tool from the prompts shown. Always check the numbers before you reuse a map.

View:

Current State: Push Production

Four steps pushed through inventory. The timeline separates 10 days of waiting from 155 seconds of processing. Known flaw: the inventory days imply a different daily demand at each step (500 pcs is 2 days, 1,200 pcs is 4 days), so recompute them from your own demand.

current statepushmanufacturing

Current State with Supermarket and Kanban

Production control, forecasts, a finished-goods supermarket, and a withdrawal kanban in one current-state map. Known flaw: the daily production schedule arrow points back up into production control instead of out to the processes.

current statekanbansupermarket

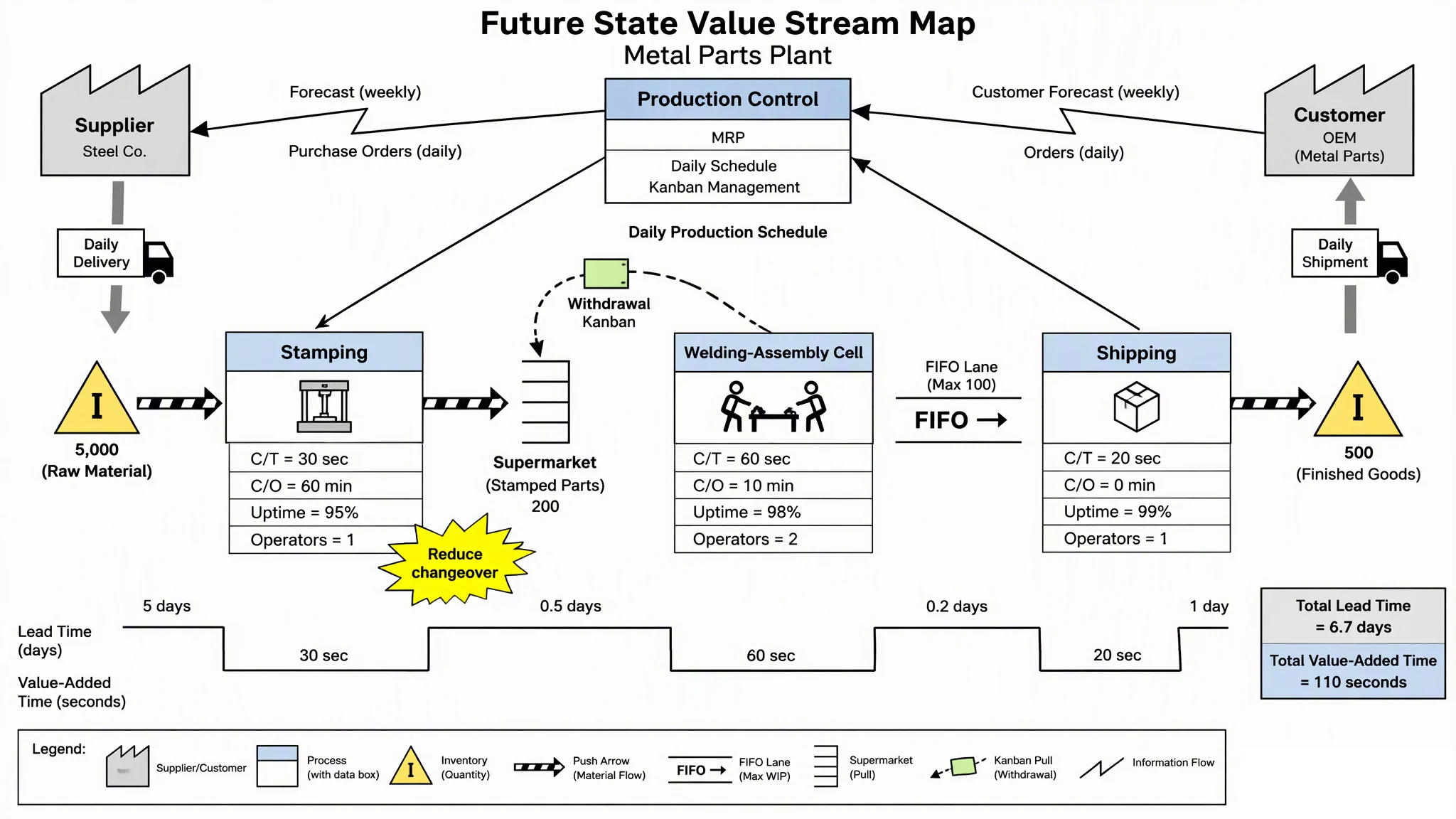

Future State: Pull and FIFO

A future state with a supermarket pull loop, a FIFO lane, and a kaizen burst on the changeover.

future statepullFIFO

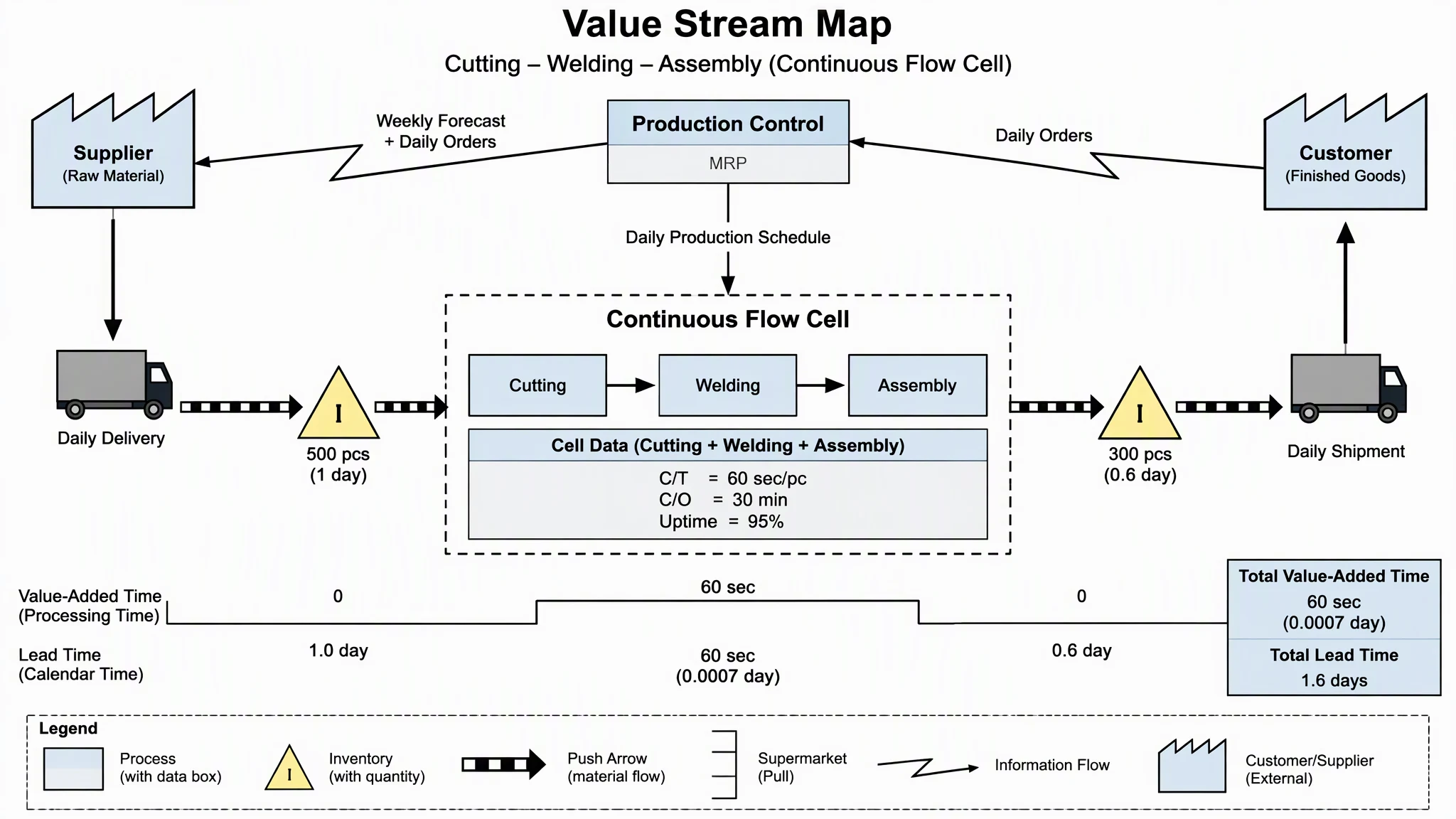

Continuous Flow Cell

Three steps grouped as one cell with a single data box, so there is no inventory between them.

continuous flowcell

Service Process: Order to Cash

An office process: queues of orders and invoices, %C&A in the data boxes, and 6.5 days of wait against 28 minutes of work. Known flaw: the WT row in each data box shows a dash, while the time ladder gives each step a wait time.

serviceofficeorder to cash

What is a value stream map template?

A value stream map template is a starting layout with the standard symbols already placed: customer and supplier at the top corners, production control in the middle, a row of process boxes with data boxes, inventory triangles between them, and a timeline ladder at the bottom. In this tool, the sample prompts above work as templates: pick one, replace the step names and numbers with yours, and generate. If you work from a printed or slide template instead, the symbol table on this page is the checklist for filling it in.

Current state vs future state map

The current-state map shows how material and information flow today, with the real inventory, cycle times, and push arrows. The future-state map redraws it with improvements applied: connected flow, supermarkets and pull signals, and a single scheduling point. Teams usually draw the current state first, mark kaizen bursts on it, then generate a future state to agree on the target and the order of improvements.

Manufacturing vs service VSM

Manufacturing maps count pieces and use cycle time and changeover time. Service and office maps count requests, orders, or patients, and usually replace the data box with process time (P/T), wait time (WT), percent complete and accurate (%C&A), and number of people. The timeline works the same way: waiting time on top, processing time below, and a ratio of value-added time to lead time at the end.

Where the maps come from

Value stream mapping grew out of the Toyota "material and information flow" diagrams and was popularized by the 1998 workbook Learning to See by Mike Rother and John Shook (Lean Enterprise Institute), which is the usual source of the symbols used here. Some companies add their own symbols or use slightly different data boxes, so follow your own standard where one exists.

Frequently Asked Questions
